;On Don Mills Road, an 18-kilometre line would stretch from Steeles Avenue in the north to the Bloor-Danforth subway in the south and run entirely on a surface dedicated right-of-way.4 On Eglinton Avenue, a 31-kilometre line would run from a new Renforth transitway station to be constructed as part of the Mississauga Transitway in the west to Kennedy Station on the Bloor-Danforth line in the east, with a short spur-line providing service to Pearson Airport.5 The line would provide a vital east-west connection through the centre of the City of Toronto and would run on a surface right-of-way between Renforth transitway station to Keele Street, then underground to Laird Drive, where it would resume running on the surface in a dedicated right-of-way until it reached Kennedy Station.6 On Finch Avenue West, an 18-kilometre line would run from the area near the intersection of Finch Avenue West and Highway 27 in the west to Finch Station on the Yonge-University line in a dedicated surface right-of-way.7 Extensions further west towards Mississauga and south towards Woodbine Racetrack and Pearson Airport were also proposed for future extensions.8 On Jane Street, a 17-kilometre line would begin at Jane Station on the Bloor-Danforth line in the south and end at Steeles West Station on the then-proposed Toronto-York Spadina Subway Extension in the north, with a spur eastward from the intersection of St. Clair Avenue and Jane Street towards Gunn Loop, the western terminus of the 512 St. Clair streetcar line.9 Originally proposed to run entirely on the surface in a dedicated right-of-way, mixed-surface and underground routings were considered during its planning.10 In Scarborough, a 15-kilometre line would start at Kennedy Station on the Bloor-Danforth line and run east along Eglinton Avenue, north-east on Kingston Road, and north on Morningside Avenue to service the University of Toronto Scarborough Campus and eventually terminate in the Malvern neighbourhood.11 The line would run in a dedicated surface right-of-way and run on the same tracks of the proposed Sheppard East LRT line for a short section in the northern part of the line approaching Malvern.12 On Sheppard East, a 14-kilometre line would run east from Don Mills Station on the Sheppard Line to the Malvern neighbourhood in the west.13 The line would connect with a proposed extension and refurbishment of the Scarborough rapid transit line to create a new transit terminal serving north-east Scarborough, providing a vital hub for transit riders in the area.14 The line would run almost entirely on a dedicated surface right-of-way except for a brief decent underground to connect with the Sheppard subway at Don Mills station, where a platform-level connection with the subway was planned. Extensions eastward towards Durham Region were proposed for future consideration.15 Along the waterfront, an 11-kilometre line connecting southern Etobicoke in the west to Exhibition Place in the east, extending current streetcar services along the waterfront between Exhibition Place and Union Station.16 Parts of the line would follow both the railway corridor adjacent and the Gardiner Expressway to connect with existing track on the Queensway and Lake Shore Boulevard, which would be upgraded to become a dedicated right-of-way.17 Extensions both west into Mississauga and east from Union Station were proposed for future consideration.18
Transit city (2007)
Cancelled
Partially under construction
The largest rapid transit plan by kilometres ever proposed for Toronto, Transit City’s vast network of light rail transit lines running across the city was the culmination of a shift towards focusing on intermediate capacity transit systems (ICTS) for transit expansion. Previous attempts utilised then-experimental linear induction motor technology, resulting in the issue-plagued Scarborough rapid transit line. Light rail vehicles running in their own right-of-ways as proposed by the Transit City plan harkens back to plans for ICTS lines utilising coupled streetcars, similar to ideas proposed by the TTC in the early 1970s and 80s.
Transit City was an ambitious transit expansion plan jointly announced by the City of Toronto and the TTC in March 2007 that called for the construction of a network of light rail transit (LRT) lines across the city.1 A total of over 120 kilometres of new rapid transit was proposed on seven corridors, six following arterial roads and a line following the waterfront. Additionally, an upgrade and extension of the Scarborough rapid transit line to Malvern using newer intermediate capacity transit system technology was included in this plan, with plans eventually changing to a refurbishment of the line to utilise the same light rail technology proposed to be utilised on the other Transit City lines. In total, the plan would cost just over $6 billion, none of which was funded at the time of the announcement, with an estimated completion date of 2021.2
Streetcar Right-of-way

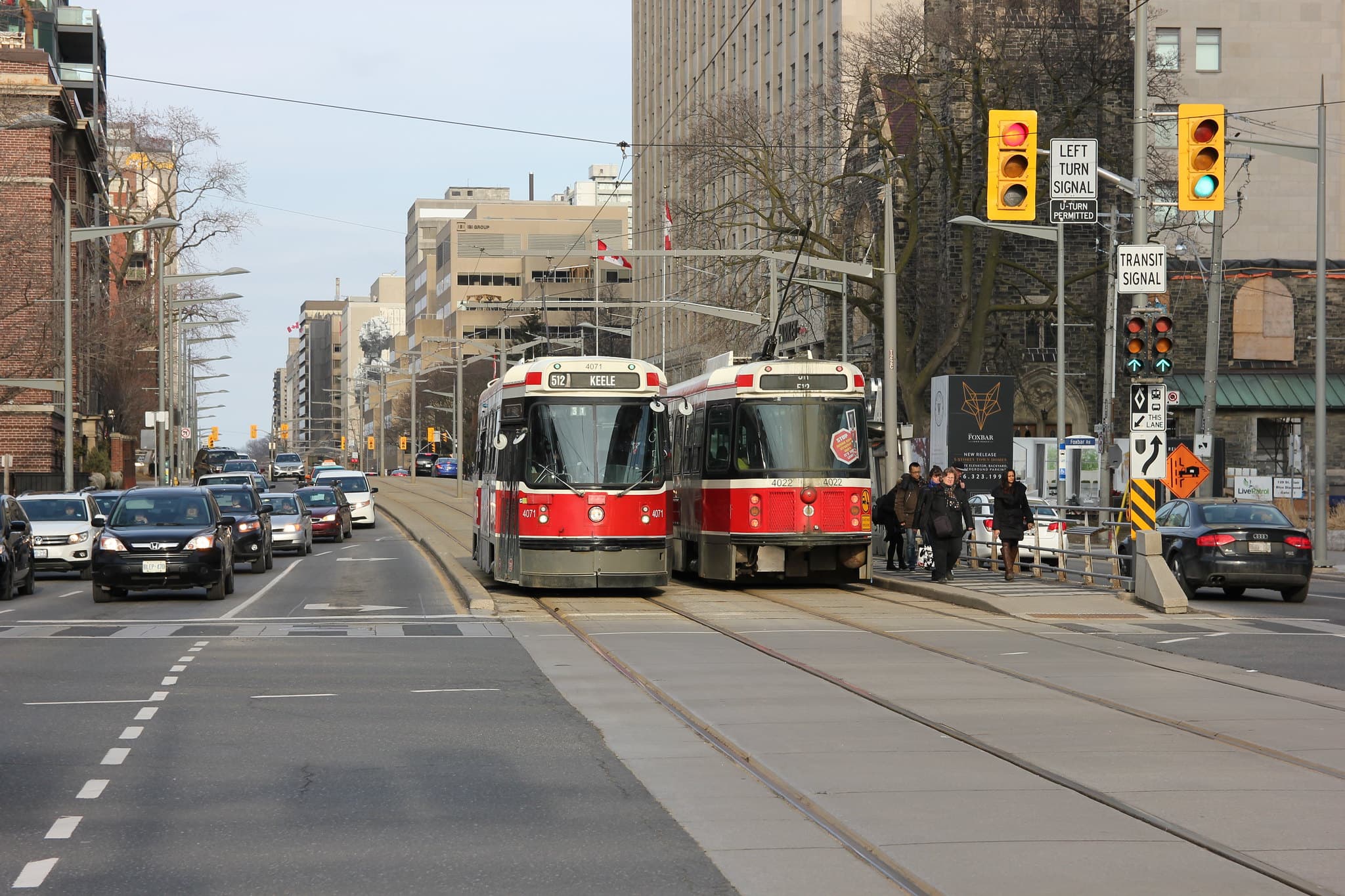

Transit City light rail lines would utilise dedicated right-of-ways to avoid being impeded by vehicular traffic.3 Similar dedicated right-of-ways had been previously implemented on streetcar routes such as the 512 St.Clair, pictured here, 510 Spadina, and the 509 Harbourfront streetcar.
“TTC 4071, 4022” by BillyCabic is licensed under CC BY-NC 2.0
Light Rail Vehicles

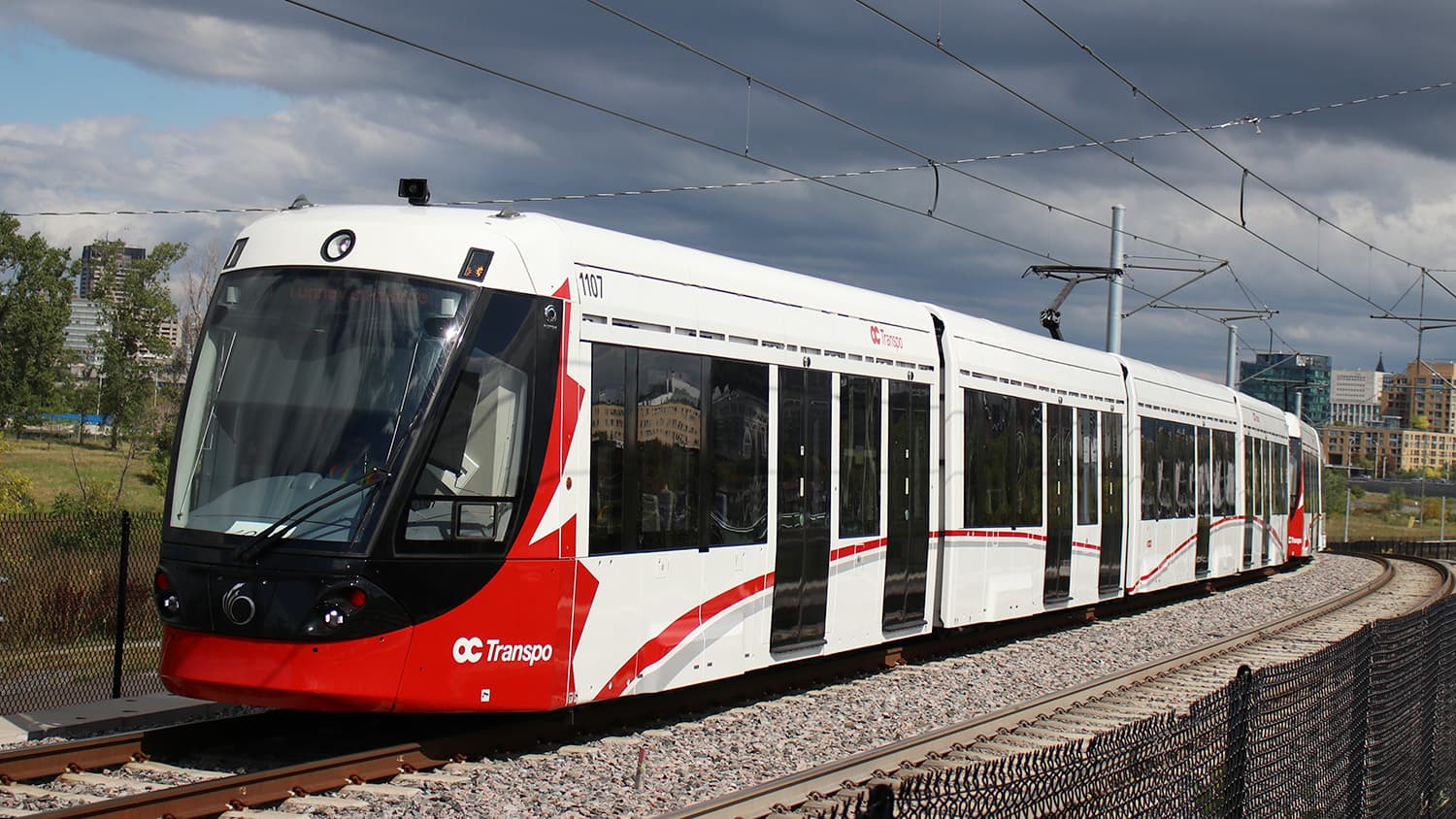

New light rail vehicles similar to the planned new streetcars were to be utilised on the new Transit City lines. The vehicles eventually selected by Metrolinx were Bombardier’s Flexity Freedom, part of Bombardier’s Flexity family of streetcars and light rail vehicles.19 Following delivery concerns of Bombardier’s vehicles, Alstom’s Citidas Spirit was selected to replace Bombardier’s vehicles for use on the Finch West LRT line, with Bombardier’s vehicles to be exclusively used on the Eglinton Crosstown LRT. Shown to the right is Bombardier’s Flexity Freedom LRV originally planned for use on all Transit City and other LRT projects in the Greater Toronto Area, but is now only planned to be used on the Eglinton Crosstown LRT line. Below that is Alstom’s Citidas Spirit LRV utilised by OC Transpo on Line 1 Confederation Line and planned to be used on the Finch West LRT line as well as the Hurontario LRT planned in Mississauga.20
“Eglinton LRT Maintenance & Storage Facility” by wyliepoon is licensed under CC BY-NC-ND 2.0
“OC Transpo O Train LRV 1107” by Youngjin is licensed under CC BY-SA 3.0
The origins for Transit City began in 2005 with the completion of the Building a Transit City study conducted by the TTC, which called for the construction of rapid transit on key thoroughfares in the city including Eglinton Avenue, Lawrence Avenue, Sheppard Avenue, Kingston Road, King Street, Queen Street, Dundas Avenue West, Bremner Boulevard, Don Mills Road, Lakeshore Boulevard, and Jane Street.21 The study prioritised lower-cost surface rapid transit options including the creation of dedicated rights-of-ways for buses and light rail transit over costly underground subway lines, crucial for the TTC in an era of both falling modes of transport market share and budgets.22
The outcome of the study was endorsed by the then-mayor of Toronto, David Miller, whose transit plan in the 2006 Toronto municipal election included light rail transit lines on Don Mills Road and along the Waterfront, as well as dedicated bus lanes on Kingston Road and Yonge Street.25 His victory in those elections advanced plans of the study towards the Transit City plan announced in 2007, but even with his re-election, plans for light rail and surface rapid transit saw little support outside of the municipality, with the provincial and federal governments funding plans for an extension of the Spadina subway line towards York instead.26 And despite the promises of cost-savings by building above-ground, funding for new transit projects was impossible, with the cash-strapped TTC faced with budget cuts of nearly $200 million early in 2005 as a result of cuts from the City of Toronto.27
Sheppard East LRT

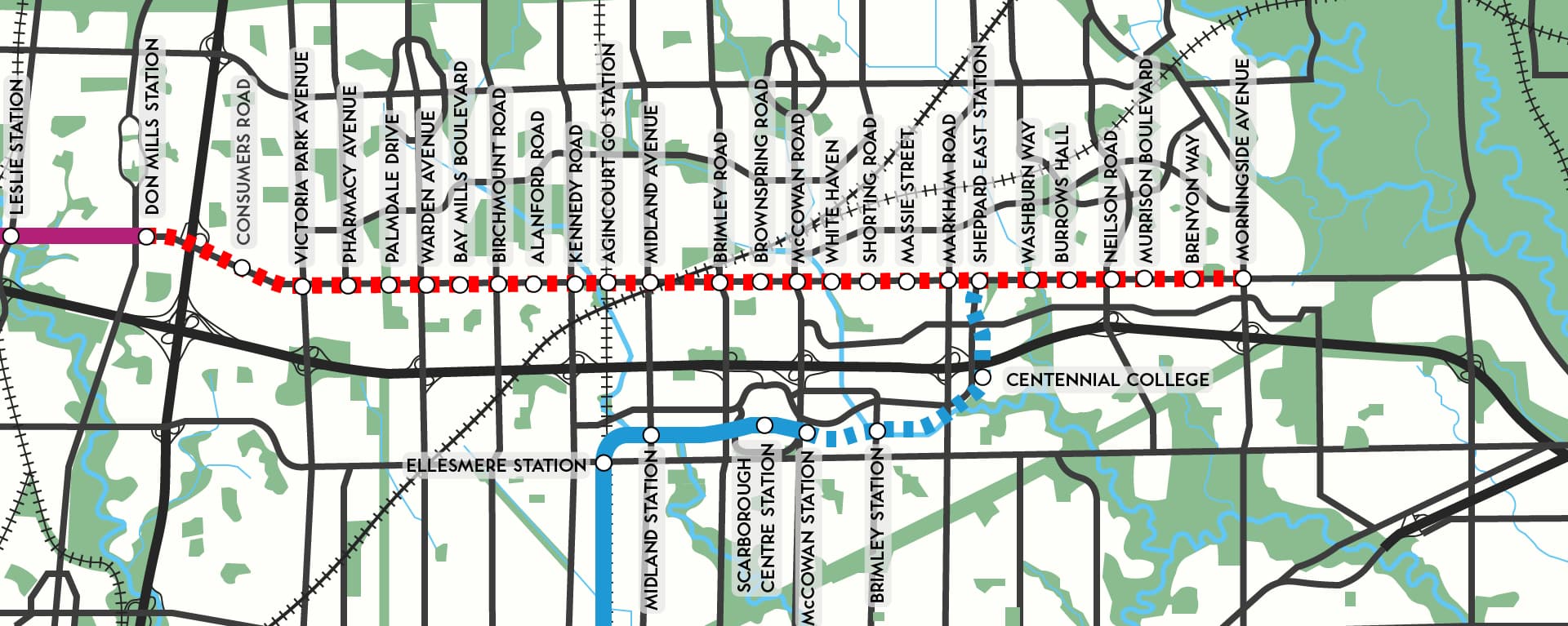

The environmental assessment of the Sheppard East LRT identified 25 new stops and an interchange with the existing Sheppard line at Don Mills Station. It was eventually cancelled in favour of an extension of the Sheppard subway in 2011, although it was later reinstated. However, the line continues to be limbo as of 2020, with long-term plans reverting to intentions for a subway extension.
Finch West LRT

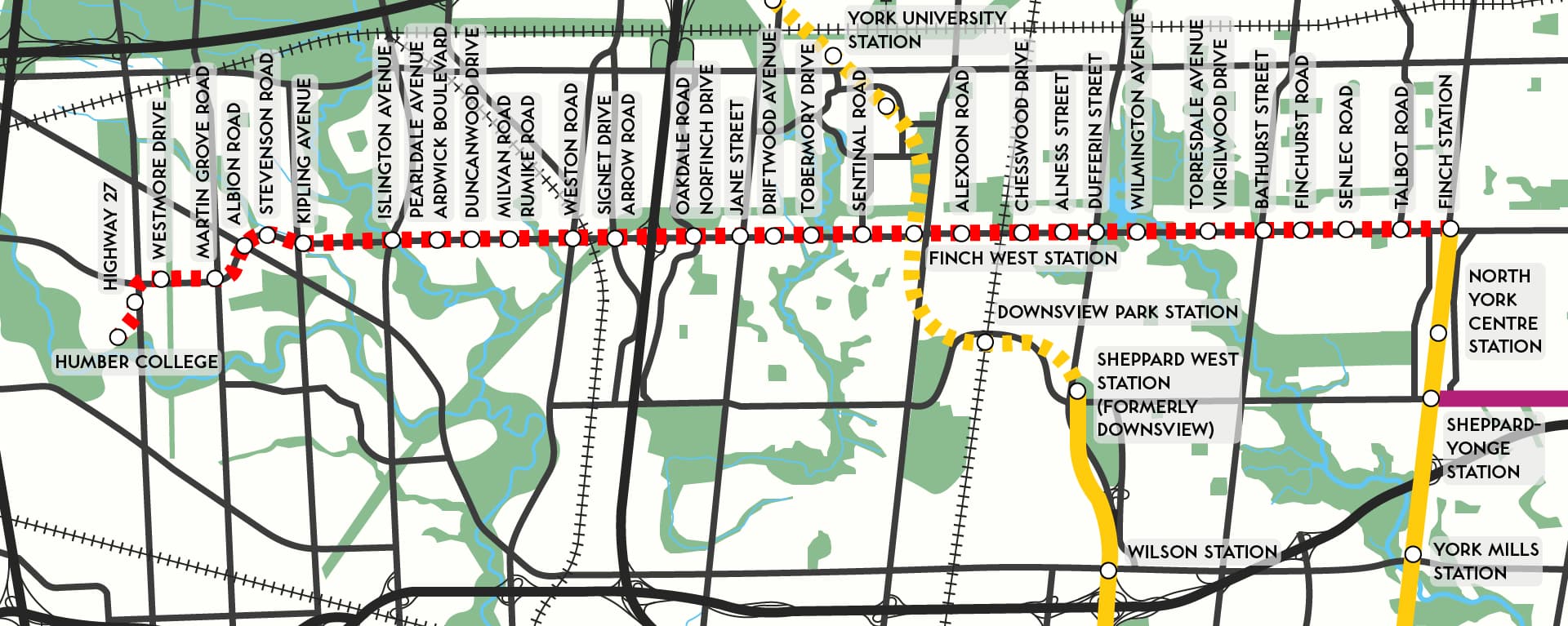

The environmental assessment of the Finch West LRT identified 31 new stops and two interchanges with the Yonge-University subway, one at the existing Finch Station and one at the then-planned Finch West Station on the Toronto-York Spadina Subway Extension. The line saw several changes during the planning process, first with the section between Finch West Station and Finch Station being cut, and later its cancellation following Rob Ford’s election as mayor.
Planning for Transit City routes had also progressed, with TTC planners deciding to extend the Finch West LRT from its eastern terminus at Finch Station on the Yonge-University line to Don Mills Station on the Sheppard line to meet the existing Sheppard subway and proposed Sheppard East LRT.28 Meanwhile, proposals to extend and refurbish the existing Scarborough rapid transit line to utilise low-floor LRT technology as proposed on other Transit City lines were considered, as was connecting the proposed reconstructed line with the proposed Eglinton LRT.29 By mid-2009, two announcements committed funding for the Sheppard East, Finch West, and Eglinton LRTs from the provincial and federal governments totalling $6.8 billion, $1 billion for the Sheppard East LRT, planned to begin construction later in the year, and $5.8 billion for the Finch West and Eglinton LRTs, which would see construction start in 2010.30
Don Mills Station
At Don Mills, TTC planners considered several options for interfacing the proposed Sheppard East LRT with the existing Sheppard subway line. Eventually, plans to have the LRT meet the existing subway at platform level were finalised, with transfers between the subway and LRT planned to be a walk from one vehicle to another.31
“TTC Line 4 Don Mills Station” by The West End is licensed under CC BY-NC-ND 2.0
However, setbacks quickly emerged for the plan, beginning with funding issues as work began to ramp up. Starting with the province postponing $4 billion on transit spending in the GTA, detailed estimates of the costs of the funded Transit City projects emerged, showing that the approved plans would cost $2 billion more than originally estimated.32 While construction on the Sheppard East LRT began in late 2009, Metrolinx revised timelines for the other two projects, delaying the completion date of projects by two years on top of the delays in postponing construction until at least 2013.33
By then, the provincial government was planned to fund the entirety of the approved Transit City projects, except for a $330 million portion from the federal government.34 Meanwhile, portions of the Sheppard East and Finch West LRTs were delayed for future phases, with the loss of a short section of the Sheppard East LRT from Morningside Avenue to Meadowvale Road, and the elimination of the section between Finch West station and Don Mills Station.35
Funded transit lines
The provincial government moved to fund three of the seven Transit City projects and an extension of the Scarborough Rapid Transit line. However, changing plans and limited funding meant several changes to the plan before construction could start. Eventually, only two of the four projects funded in 2009 began construction.
More worrying, however, was the upcoming 2010 Toronto municipal elections, with front-runner (and eventual mayor-elect) Rob Ford campaigning on ending the “war on the car” by cancelling Transit City, which projects would have run on a dedicated surface right-of-way in the median of roads, removing left-turn lanes found in the centre-median lanes.36 His election and the eventual cancellation of Transit City projects on the first day of taking office in favour of his transit plan, namely the completion of the Sheppard subway as proposed in Network 2011 (Downsview to Scarborough Centre), put the city at odds with the province, which had already spent $130 million on planning and $1.3 billion in contracts related to tunnel-boring machines and light rail vehicles.37
However, work underway on the Sheppard East LRT continued, with the work underway grade-separating the Stouffville GO line tracks from Sheppard Avenue necessary for either an LRT or a subway.38 Ultimately, negotiations between the city and the province resulted in a revised plan for transit in the city, one that transferred all provincial funding related to Transit City to a new fully-underground Eglinton LRT, along with an extension of the Sheppard subway to be built with municipal and private funding.39
Today, portions of Transit City survive, both in plans and in-reality. Further developments in city council eventually restored the pre-Ford election plans for light rail, and the Eglinton LRT began construction in 2011, with the Finch West LRT delayed several times by the provincial government until preparation work began in 2019. A Sheppard East LRT was later put on-hold, and eventually cancelled, with the current provincial government planning for an eventual extension of the Sheppard subway to approximately the intersection of Sheppard Avenue and McCowan Road.40
Eglinton Crosstown Construction

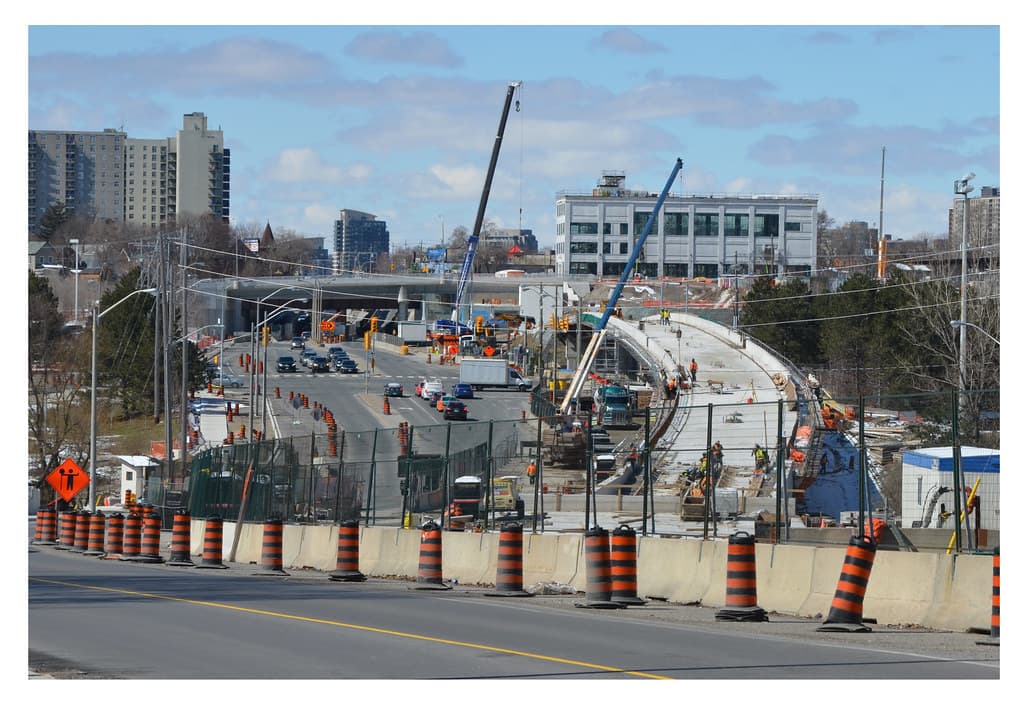

Construction on the Eglinton Crosstown began in 2011 with a total of 25 stations and stops, underground and aboveground. Pictured is the western portal located east of Mount Dennis Station where trains will run elevated over Black Creek Drive.41
“working at the western end” by Mary Crandall is licensed under CC BY-NC-ND 2.0
Meanwhile, plans for rapid transit on Don Mills survives as studies for originally, the Relief Line North rapid transit and now the Ontario Line, a proposed rapid transit line that integrates elements of the cancelled Relief Line and the proposed Don Mills LRT. Both Jane Street and the waterfront LRTs remain on TTC and City of Toronto plans for future study, while plans for a Scarborough-Malvern LRT are currently being studied as part of an extension of the Eglinton LRT eastwards. More than ten years on, elements of Transit City have continued to be relevant in transit planning in Toronto, and two lines originally proposed as part of the plan are under construction and planned to open in the near future.
